Rockwall Zoning Permits: Checklist for Businesses
Step-by-step checklist for Rockwall zoning permits: verify zoning, schedule a pre-application meeting, prepare site plans, pay fees, and expect 30–60 day reviews.
Rockwall Zoning Permits: Checklist for Businesses
Starting a business in Rockwall, Texas? Here's what you need to know about zoning permits:
- Zoning Compliance: Confirm your property's zoning district using Rockwall's Interactive Map and ensure your business activities align with the Unified Development Code (UDC).
- Special Permits: Some businesses require a Specific Use Permit (SUP) or zoning change, which can take 45-60 days to process.
- Pre-Application Meeting: Schedule a meeting (held Thursdays) to identify potential issues and clarify requirements.
- Application Process: Submit a Development Application with required fees ($200 base + $15/acre) and supporting documents like site plans, property details, and legal descriptions.
- Site Plan Requirements: Include zoning details, building locations, utility connections, and landscaping plans.
- Approval Timeline: Site plan reviews take ~30 days; zoning changes or SUPs require ~45 days.
Plan ahead to avoid delays and ensure your business meets Rockwall's zoning regulations.

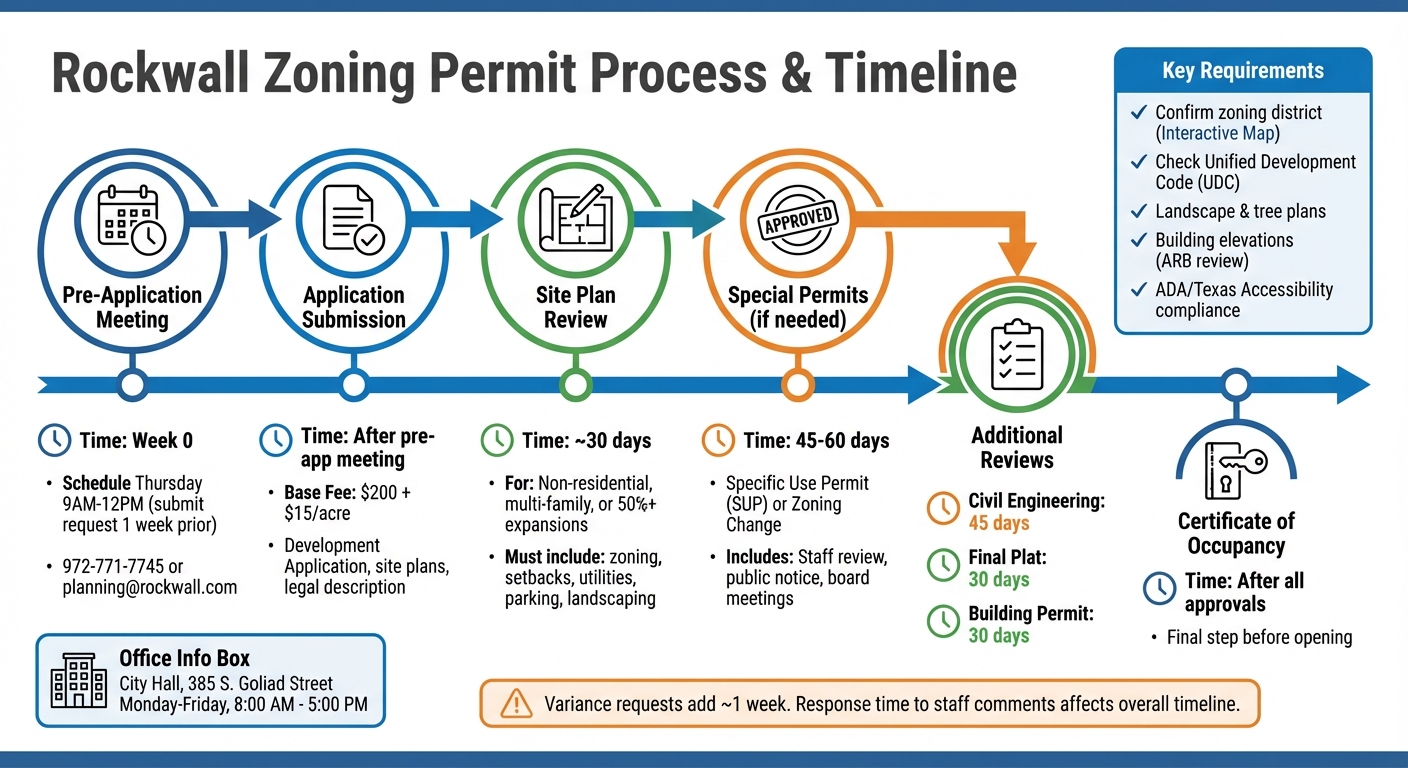

Rockwall Business Zoning Permit Timeline and Process
What Business Licenses are Needed in Texas - Starting a Business in Texas
sbb-itb-bbaa742
Before You Apply: Preparation Checklist
Getting your paperwork in order before applying can save you time and prevent unnecessary delays. To ensure your permit application process goes smoothly, follow these steps to confirm your zoning district, identify any special permit requirements, gather the necessary documents, and explore Rockwall area businesses for local context.
Check Your Property's Zoning District
The first step is to identify your property's zoning district. Use the City of Rockwall's Interactive Map to locate your property and find its zoning designation. Once you have this information, consult the Unified Development Code (UDC) to see what business activities are allowed in that zone. The UDC's Land Use Schedule will indicate whether your business type is permitted "by right" or if additional approvals are required.
If you need help navigating the process, reach out to the Planning & Zoning Department. You can contact them by phone at 771-7745 or email at planning@rockwall.com. Their office is on the first floor of City Hall at 385 S. Goliad Street and is open Monday through Friday, 8:00 AM to 5:00 PM.
Identify Special Permit Requirements
Once you’ve confirmed your zoning district, check if your business activity requires additional permits. Not all businesses are permitted in every zone. If your proposed activity isn’t allowed "by right", you may need a Specific Use Permit (SUP) or even a zoning change. These processes can take anywhere from 45 to 60 days from the time you submit your application to the final ordinance reading.
The city strongly advises scheduling a pre-application meeting before submitting your formal documents. These meetings are held every Thursday between 9:00 AM and 12:00 PM, but you’ll need to submit a request form at least one week in advance. During the meeting, city planning staff will help you identify any potential challenges and clarify whether you need an SUP, a zoning change, or a Planned Development district designation.
If your property is located in a Historic District or an existing Planned Development, be aware that additional design and material standards may apply, which could impact the approval process.
Collect Property and Legal Information
To complete your application, you’ll need specific details about the property. This includes the legal property description and information about the current owner.
Make sure to obtain the official Development Application and review the city’s Development Calendar to ensure you meet submission deadlines. Having these documents ready before your pre-application meeting can streamline the process and allow city staff to provide more precise guidance for your project.
For additional resources, the Planning Department maintains a Planning Archive with records of past development cases, approved plats, and site plans. These can be valuable references as you prepare your application.
Zoning Application Submission Checklist
Once your documents are ready, follow these steps to submit your zoning application or Specific Use Permit (SUP) request. Use the checklists provided to ensure your submission meets all requirements.
Application Forms and Fees
Start by filling out the necessary forms and paying the required fees. Submit a completed Development Application along with the appropriate checklist - either the Checklist for Plats or the Checklist for Site Plans, depending on your project type. Be sure to adhere to the deadlines outlined in the 2026 Development Calendar to avoid any processing delays.
The fee structure for zoning changes or SUPs includes a $200 base fee plus $15 per acre. Payments must be made at the Planning & Zoning Department, located at City Hall, 385 S. Goliad Street. These fees are due at the time of submission and cover the city's review and processing of your application.
Property and Business Information
Your submission should include the property address, zoning district, legal description, and contact details for the property owner or an authorized agent. Additionally, provide a clear and detailed description of your proposed land use. Avoid vague language, as incomplete or unclear descriptions can result in delays or requests for more information.
Required Supporting Plans
The type of supporting plans you'll need to include depends on your project. For a zoning change or a Planned Development designation, submit concept plans that illustrate how the property will be utilized. If your project involves new non-residential developments, multi-family projects, or building expansions exceeding 50% of the existing footprint, you must include a formal site plan with your application.
Site Plan Requirements Checklist
If you're working on a new non-residential project, a multi-family development, or planning an expansion that exceeds 50%, you'll need to submit a formal site plan that meets specific technical criteria. These guidelines are in place to ensure your project aligns with Rockwall's development standards. The Planning & Zoning Department will review your submission for compliance with the Unified Development Code (UDC), zoning ordinances, and subdivision regulations.
Basic Site Plan Components
Your site plan must include essential details like a title block, north arrow, legal description, zoning district, building locations, and required setbacks. Additionally, all utility connections - such as water, sewer, electric, and gas - must be clearly marked. For a detailed list of requirements, download the official Checklist for Site Plans from the Planning & Zoning Resource Center.
Landscaping, Parking, and Site Features
Rockwall's UDC outlines specific rules for landscaping, parking, and visibility at intersections and driveways. Your site plan should clearly show:
- Total parking spaces with dimensions
- Percentage of landscaped areas
- Visibility triangles to ensure safe sightlines at driveways and intersections
If landscaping inspections are required, you'll also need to submit a separate Landscape Inspection Request.
Signage and Building Elevations
Include the locations and types of proposed signage, along with detailed building elevations and materials for review by the Architectural Review Board (ARB). For sign permits, reach out to the Plans Examiner at 772-6774. These details are critical for moving your project to the next stage of the review process.
Additional Plans and Permits
Once your site plan review is complete, the next step is preparing additional documents to secure zoning approval. These documents ensure compliance with Rockwall's architectural and accessibility guidelines, setting the stage for a smooth construction process and eventual occupancy.
Landscape and Tree Plans
You'll need to submit a formal Landscape Inspection Request along with a detailed plan that aligns with the city's greenery and treescape standards. This plan must meet the landscaping requirements outlined in the Unified Development Code, including specific percentages, approved plant types, and tree preservation guidelines. If your project involves removing or transplanting significant trees, it's a good idea to coordinate with the Planning & Zoning Department early in the process to ensure all preservation rules are followed.
Building Elevations and Materials
To maintain Rockwall's distinct community character, the Architecture Review Board (ARB) reviews building elevations and material details. During construction, you'll need to submit a Materials Mock-up Inspection Request to confirm that your exterior finishes, colors, textures, and architectural details match the approved specifications. If your project is in a historic district, additional approval may be required through a Certificate of Appropriateness from the Historic Preservation Advisory Board (HPAB).
Next Steps After Zoning Approval
Once zoning approval is secured, the process continues with submitting civil engineering plans, which typically take about 45 days for review. Following that, file a Final Plat (30 days) and apply for a building permit (30 days), ensuring compliance with both Texas Accessibility Standards and ADA requirements. Before opening your business, you'll also need to obtain a Certificate of Occupancy.
Review and Approval Timeline
Understanding the duration of each phase in the approval process is crucial for planning your business opening. The City of Rockwall offers clear timelines for most development procedures, though the exact duration can vary depending on how quickly responses are provided.
Expected Approval Timeframes
For site plan reviews involving non-residential or multi-family developments, the process usually takes about 30 days from submission to approval. If your project requires a variance, you should anticipate an additional week to the timeline. When it comes to zoning changes or Specific Use Permits (SUP), the process generally spans 45 days, starting from the application submission to the final ordinance reading. This period includes staff reviews, public notice requirements, and meetings with relevant boards and commissions.
If you have questions or need to schedule a review, you can contact the Planning & Zoning Department at 972-771-7745 or via email at planning@rockwall.com. Next, let’s explore how the staff review process and variances might impact your timeline.
Staff Review Process and Variances
After the initial timeframes, the staff review process or the need for variances can extend the overall timeline. During this stage, city staff ensures your application complies with the Unified Development Code (UDC), subdivision regulations, and the Comprehensive Plan. The speed of approval heavily depends on how quickly you respond to staff comments. For instance, civil engineering reviews typically take 45 days, but delays in responses can prolong the process.
In cases where your project doesn’t meet specific UDC requirements, you may need to apply for a variance through the Board of Adjustment (BOA). Delays often arise from incomplete applications, missing documents, or the need for additional board reviews. To streamline your process, the City provides a Development Calendar for 2026, which outlines submission deadlines and meeting schedules. Referring to this calendar early can help you avoid conflicts and unnecessary delays, ensuring your application stays on track.
Final Tips for Rockwall Business Owners
Before diving into your project, make sure to schedule a pre-application meeting. These meetings take place every Thursday morning from 9:00 AM to 12:00 PM, but you’ll need to submit a written request at least a week ahead of time. According to the City of Rockwall Planning and Zoning Department, "A Pre-Application meeting is typical the starting point for all projects and is strongly recommended prior to submitting a development application". This step can help you avoid costly delays by addressing potential issues early on.
Pay attention to the mandatory checklists required for different project types, such as signs, plats, and site plans. You can download the appropriate forms from the Planning and Zoning Department’s website. Double-check that you’ve completed every item on the checklist before submitting your application. If you’re unsure about anything, city staff are available to provide valuable guidance.
If you’re planning to lease or purchase property, contact the Planning & Zoning Department to confirm whether your intended business use is allowed in the zoning district you’re considering. This could save you from committing to a property that doesn’t meet zoning requirements.
Take advantage of the 2026 Development Calendar. It’s also worth exploring the department’s archive, which goes back to 1970, to see how similar projects have been managed in the past. These insights can give you a clearer idea of what to expect during the approval process.
For extra support, check out RockwallConnect.com, a local directory that connects you with professionals experienced in navigating Rockwall’s development process. These experts are familiar with the Unified Development Code and local requirements, making it easier to tackle the permitting process with confidence.
FAQs
How can I make sure my business complies with Rockwall's zoning regulations?
To make sure your business aligns with Rockwall's zoning rules, your first step should be reaching out to the city's Planning and Zoning Department. They’re your go-to resource for specific zoning details based on your business type and location. You can easily contact them via phone or email for tailored guidance.
Next, take a look at the Unified Development Code for Rockwall. This document breaks down what activities are permitted in each zoning district. By checking your property’s zoning classification here, you can confirm whether your business operations are allowed in your area.
Still feeling uncertain? You might want to schedule a consultation or request a zoning verification letter from the city. These extra steps can save you from potential headaches and help ensure your business is operating within local guidelines.
Does my business in Rockwall need a Specific Use Permit (SUP) or a zoning change?
To determine whether your business in Rockwall requires a Specific Use Permit (SUP) or a zoning change, start by checking the current zoning classification of your property. This will help you understand what activities are allowed within that zone. If your intended business activity isn’t permitted under the existing zoning, you may need an SUP, which grants approval for specific uses through the City Council.
The process for obtaining an SUP involves submitting an application, attending public hearings, and securing approvals from both the Planning & Zoning Commission and the City Council. This typically takes about 60 to 90 days. If your plans involve more extensive changes, such as altering the land use, you’ll likely need to apply for a zoning change. Like the SUP process, this also requires public hearings and notification to nearby property owners.
If you’re uncertain about the requirements, reaching out to the City of Rockwall’s Planning & Zoning Department is the best way to get personalized advice for your property and business plans.
What documents do I need to apply for a zoning permit in Rockwall?
To get a zoning permit in Rockwall, you’ll need to submit a completed application form, along with detailed property information and any required plans or supporting documents outlined by the Planning & Zoning Department.
Double-check the specific requirements for your project to prevent delays and make sure all the necessary paperwork is ready before you submit your application.
